Launching of all Concourse Arms of HRBR Layout Station completed.

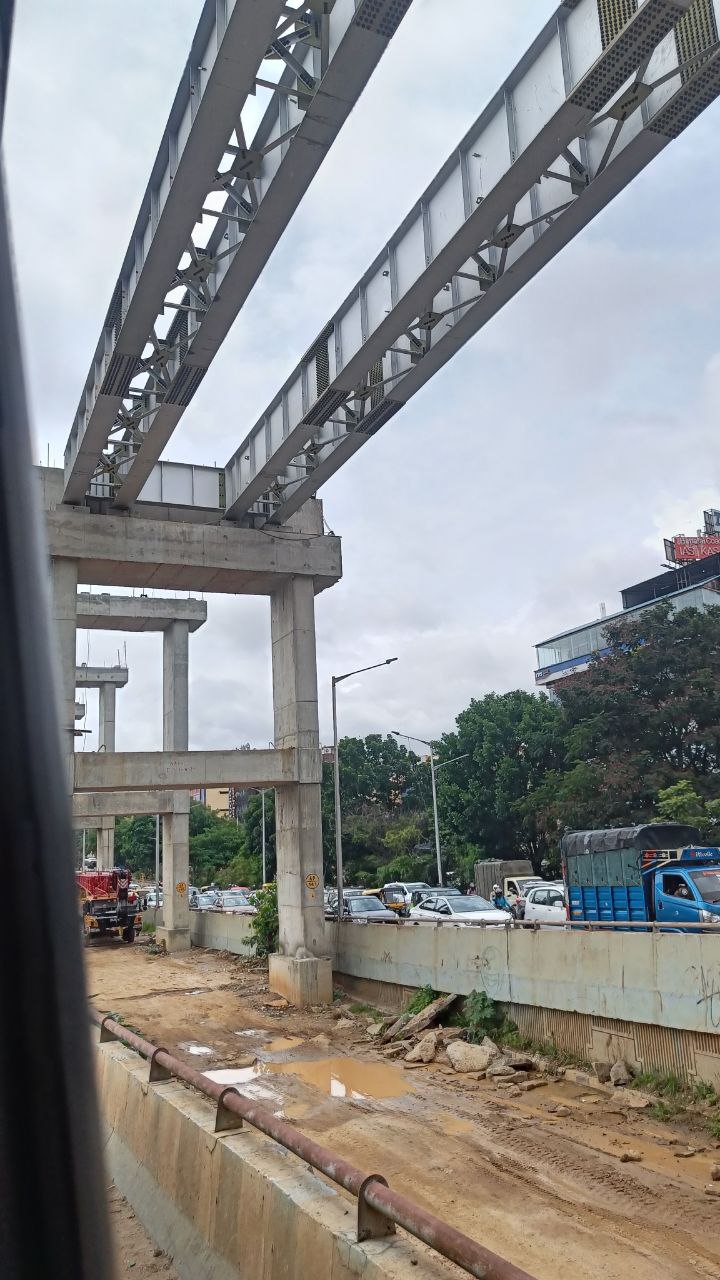

1st Platform Arm of Kalyannagara Station launched.
1st Concourse Arm of Kalyannagara Station launched.

Launching of all Platform Pier Caps of Kalyannagara Station completed.
JULY
2025
ISSUES:
Delays in Station works.

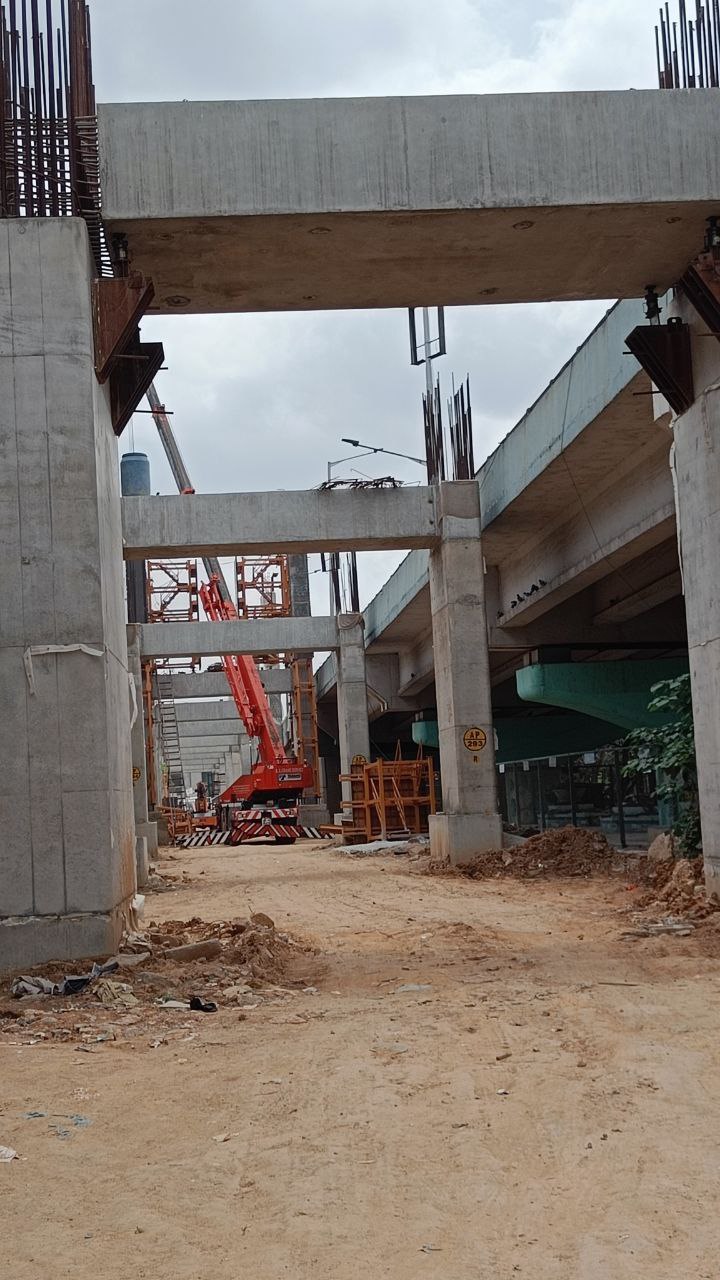

Delays in Cantilever Pier works between HBR Layout Station to Veerannapalya.

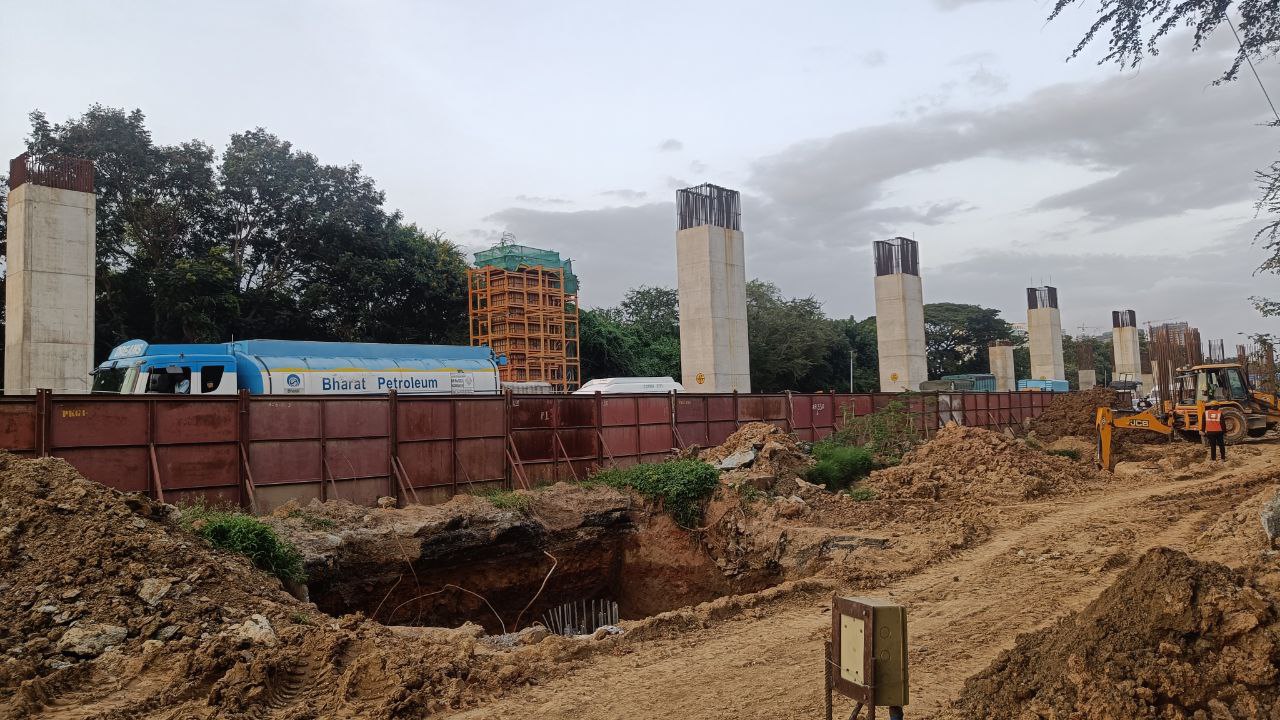

Delays in Pier works between Benniganahalli to Kasturinagara.
Railways have taken up RUB works in metro path at Benniganahalli, holding up the metro work.

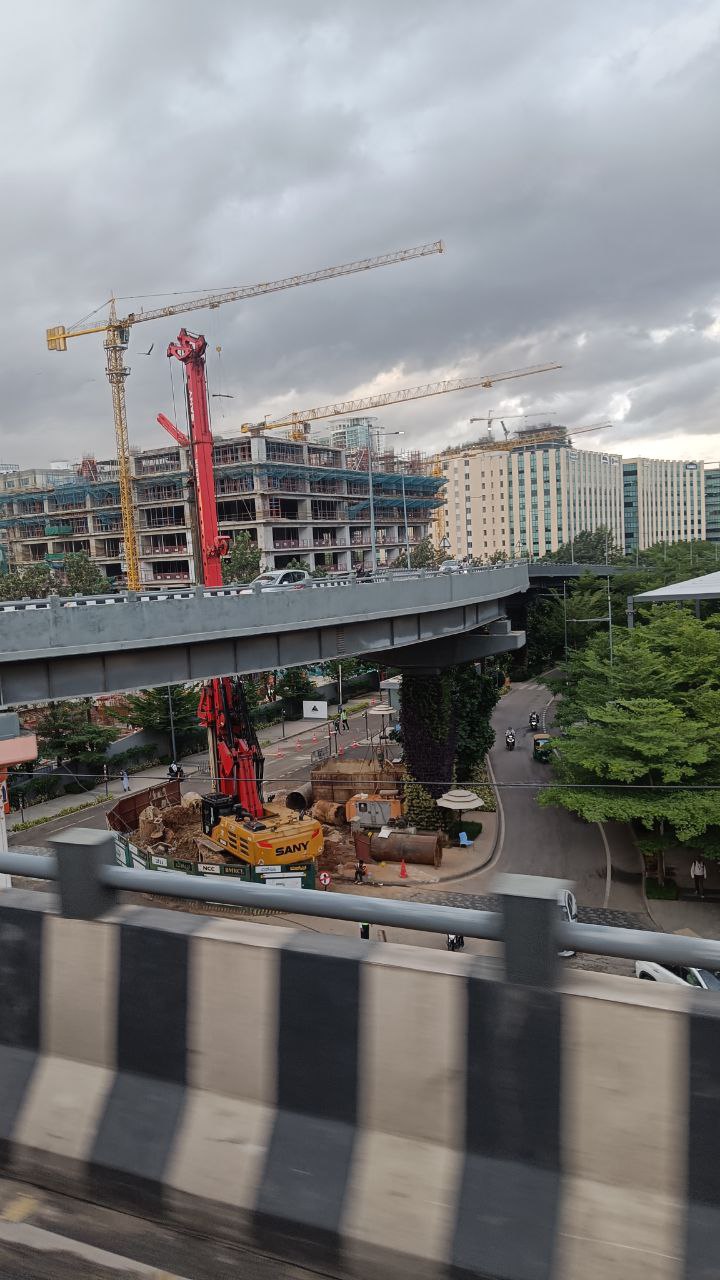

Continuous changes in scope and delays in release of designs is delaying the project.
Progress In The Month

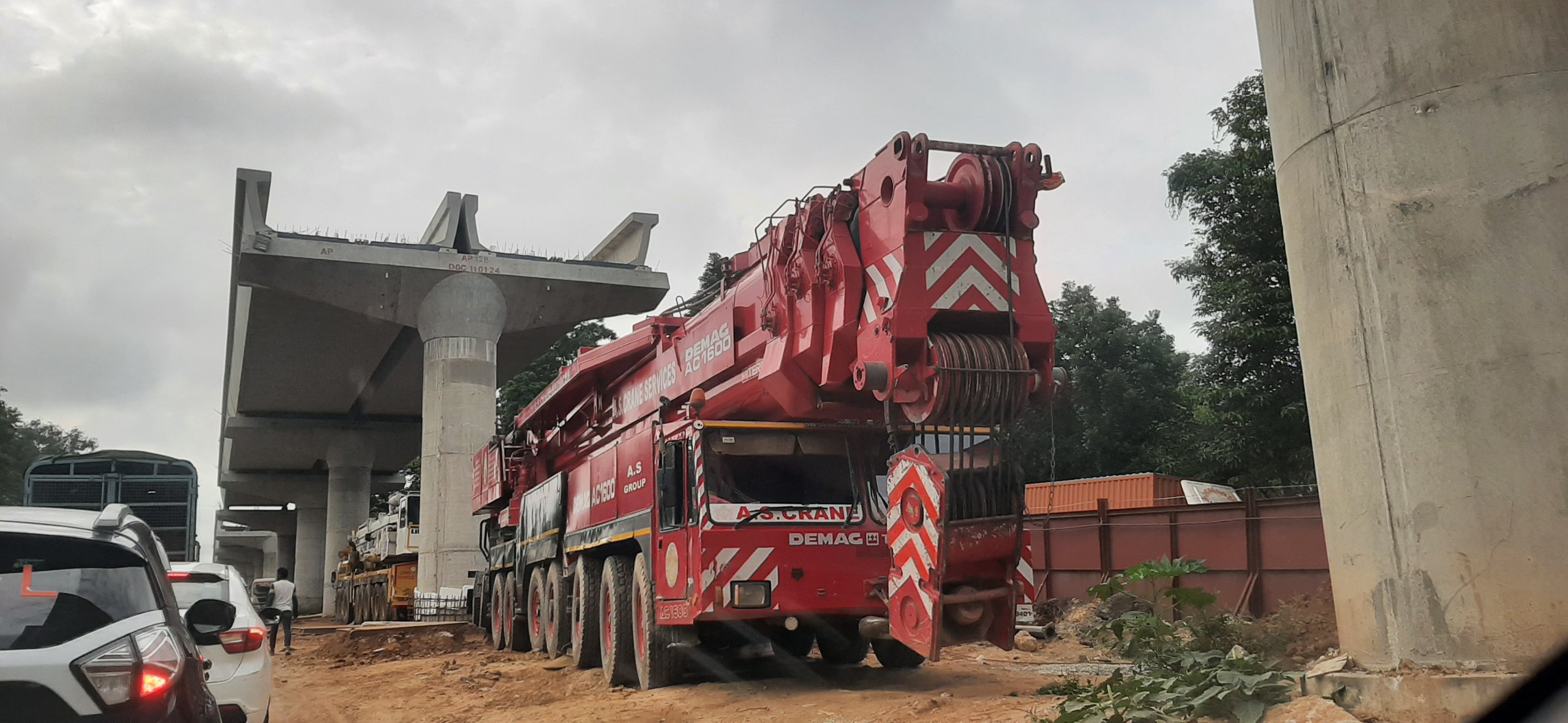

U Girders Progress In Last 6 Months

STATIONS PROGRESS
Select Station:
DESCRIPTION
TOTAL
COMPLETED
COMPLETION
Piers GL To CL
8
7
CCL Pier Cap
8
0
Pier CL To TL
8
0
PFL Pier Cap
8
0
PFL Arms
16
0
CCL Arms
16
0
CCL RCC/I-Girder Spans
42
0
PFL RCC/I-Girder Spans
28
0
U Girders
14
0
NOTE ON STATION'S PROGRESS TABLE:
STATION'S PROGRESS BEING REPORTED CONSISTS ONLY OF MAIN GRID IN MEDIAN. OTHER THAN THIS, SECONDARY WING PIERS ON SERVICE ROAD MEDIAN, SECONDARY WING CAPS, GIRDERS, CONCOURSE SLAB, PLATFORM SLAB, SECONDARY WING SLAB, ENTRY/EXIT STRUCTURE COLUMNS, STAIRCASES, ROOMS, ROOF ETC WORKS ARE NOT BEING TRACKED AS THE SCOPE DATA IS NOT AVAILABLE AND ALSO DIFFICULT TO TRACK BY PUBLIC DUE TO VISIBILITY ISSUES.
